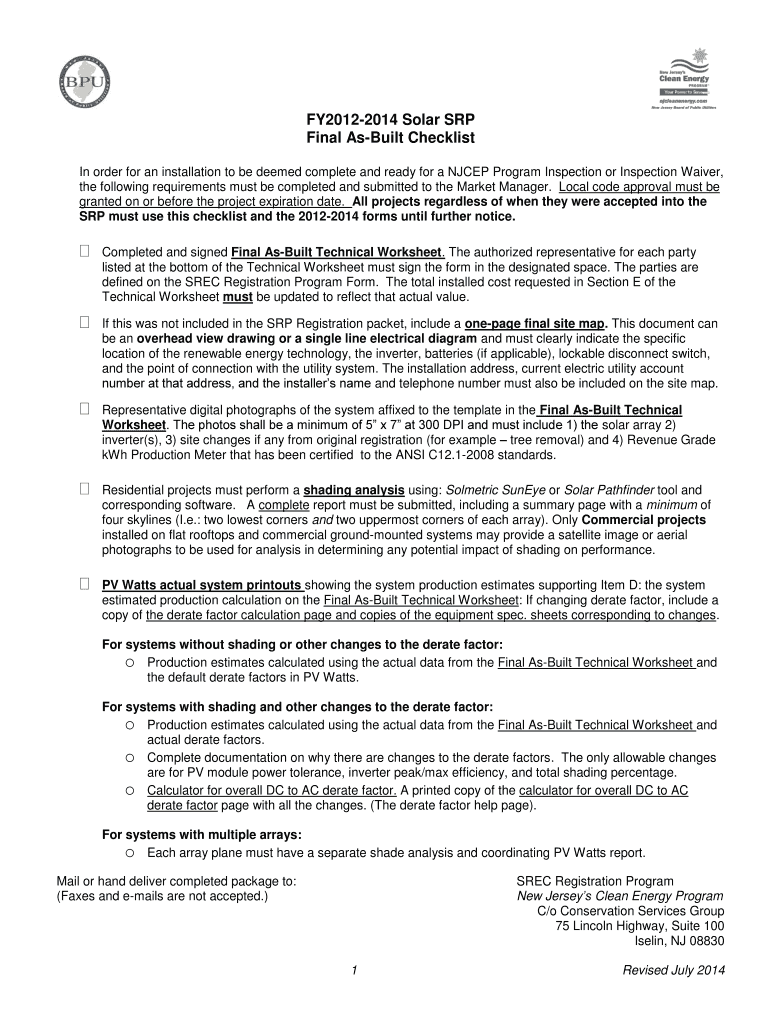

FY20122014 Solar SRP
Final Built Checklist
In order for an installation to be deemed complete and ready for a NJ CEP Program Inspection or Inspection Waiver,
the following requirements must be completed
We are not affiliated with any brand or entity on this form
Get, Create, Make and Sign final as-built checklist

Edit your final as-built checklist form online
Type text, complete fillable fields, insert images, highlight or blackout data for discretion, add comments, and more.

Add your legally-binding signature
Draw or type your signature, upload a signature image, or capture it with your digital camera.

Share your form instantly
Email, fax, or share your final as-built checklist form via URL. You can also download, print, or export forms to your preferred cloud storage service.
How to edit final as-built checklist online
To use the services of a skilled PDF editor, follow these steps below:
1
Check your account. It's time to start your free trial.
2
Simply add a document. Select Add New from your Dashboard and import a file into the system by uploading it from your device or importing it via the cloud, online, or internal mail. Then click Begin editing.
3
Edit final as-built checklist. Rearrange and rotate pages, add and edit text, and use additional tools. To save changes and return to your Dashboard, click Done. The Documents tab allows you to merge, divide, lock, or unlock files.
4
Save your file. Select it in the list of your records. Then, move the cursor to the right toolbar and choose one of the available exporting methods: save it in multiple formats, download it as a PDF, send it by email, or store it in the cloud.
Dealing with documents is simple using pdfFiller. Try it right now!
Uncompromising security for your PDF editing and eSignature needs
Your private information is safe with pdfFiller. We employ end-to-end encryption, secure cloud storage, and advanced access control to protect your documents and maintain regulatory compliance.
How to fill out final as-built checklist

01
Start by gathering all relevant documents and information related to the project. This may include architectural and engineering drawings, specifications, permits, and any construction contracts.
02
Review the project documentation to ensure that all changes and modifications that were made during the construction process are accurately reflected in the final as-built checklist. This involves comparing the original plans with the completed work.
03
Take a comprehensive walk-through of the project site, inspecting all aspects of the construction including structural elements, electrical systems, plumbing, HVAC, and any other relevant components. Take note of any discrepancies or deviations from the initial plans.
04
Use the final as-built checklist to document all the revisions and alterations that were made during the construction process. This includes updating drawings, specifications, and any other project documentation.
05
Ensure that all necessary permits and approvals are obtained and properly recorded in the as-built checklist. This may involve coordinating with local building authorities or other regulatory agencies.
06
Review the final as-built checklist with the project team, including the architects, engineers, contractors, and any other relevant stakeholders. Address any outstanding issues or discrepancies and make necessary revisions.
07
Obtain sign-offs from all parties involved in the project, indicating their agreement with the final as-built checklist. This may include signatures from the project manager, architect, engineer, subcontractors, and any other key individuals.
08
Keep a copy of the final as-built checklist for future reference and record-keeping purposes. This document may be required for any future inspections, renovations, or maintenance work on the project.
Who needs final as-built checklist?
01
Contractors and construction companies need the final as-built checklist to ensure that the completed project matches the approved plans and specifications.
02
Architects and engineers rely on the final as-built checklist to update their drawings and documentation, ensuring accurate records of the project.
03
Building owners or clients need the final as-built checklist to have a comprehensive understanding of the completed project and to comply with any regulatory requirements.
04
Regulatory authorities and building inspectors may request the final as-built checklist to ensure that the construction meets all relevant codes and regulations.
05
Future contractors, maintenance personnel, or renovation teams may require the final as-built checklist to understand the existing infrastructure and make informed decisions for future work.
Fill
form
: Try Risk Free
For pdfFiller’s FAQs
Below is a list of the most common customer questions. If you can’t find an answer to your question, please don’t hesitate to reach out to us.
Can I edit final as-built checklist on an iOS device?
Use the pdfFiller mobile app to create, edit, and share final as-built checklist from your iOS device. Install it from the Apple Store in seconds. You can benefit from a free trial and choose a subscription that suits your needs.
How can I fill out final as-built checklist on an iOS device?
Download and install the pdfFiller iOS app. Then, launch the app and log in or create an account to have access to all of the editing tools of the solution. Upload your final as-built checklist from your device or cloud storage to open it, or input the document URL. After filling out all of the essential areas in the document and eSigning it (if necessary), you may save it or share it with others.
Can I edit final as-built checklist on an Android device?
You can make any changes to PDF files, like final as-built checklist, with the help of the pdfFiller Android app. Edit, sign, and send documents right from your phone or tablet. You can use the app to make document management easier wherever you are.
What is final as-built checklist?
The final as-built checklist is a document that verifies that construction or renovation work has been completed according to plans and specifications.
Who is required to file final as-built checklist?
The contractor or builder responsible for the construction or renovation project is required to file the final as-built checklist.
How to fill out final as-built checklist?
The final as-built checklist should be filled out by providing accurate information about the completed work, including any deviations from the original plans.
What is the purpose of final as-built checklist?
The purpose of the final as-built checklist is to document the changes made during construction and ensure compliance with building codes and regulations.
What information must be reported on final as-built checklist?
The final as-built checklist must include details such as any modifications made, materials used, and any inspections conducted during the construction process.
Fill out your final as-built checklist online with pdfFiller!
pdfFiller is an end-to-end solution for managing, creating, and editing documents and forms in the cloud. Save time and hassle by preparing your tax forms online.

Final As-Built Checklist is not the form you're looking for?Search for another form here.
Relevant keywords
Related Forms
If you believe that this page should be taken down, please follow our DMCA take down process
here
.
This form may include fields for payment information. Data entered in these fields is not covered by PCI DSS compliance.
